Procedure Wooden house Lefkada 4 CLT phases

4 Phases of Building a Wooden House in Lefkada

Building a wooden house in Lefkada becomes much clearer when the process is broken into four phases: feasibility, engineering, production and assembly. This is especially important for CLT homes, where decisions made early affect cost, timing and quality.

Because order counts

Because in Lefkada, the order of construction of a wooden house determines the result

On the mainland, a mistake at the start is easier to correct. In Lefkada, mistakes cost more: bridge access, narrow roads, seasonal loads, construction windows before the tourist season, Zone III seismic regulations and winter humidity.

That is why the construction of a wooden house in Lefkada needs a clear sequence of phases. Each phase is locked before the next one begins and the owner knows exactly what they are paying for, when and why.

This sequence also protects the project engineer. Decisions on form, static system, installations, roof and shell are not made piecemeal on site, but transferred to drawings, pre-measurements and technical documentation before the CLT panels are ordered. For the most common problems before choosing a system, see them 7 mistakes before choosing a wooden house in Lefkada.

4 phases

From study to turnkey, the sequence we apply

01

Phase 1, Land, license and logistics in Lefkada

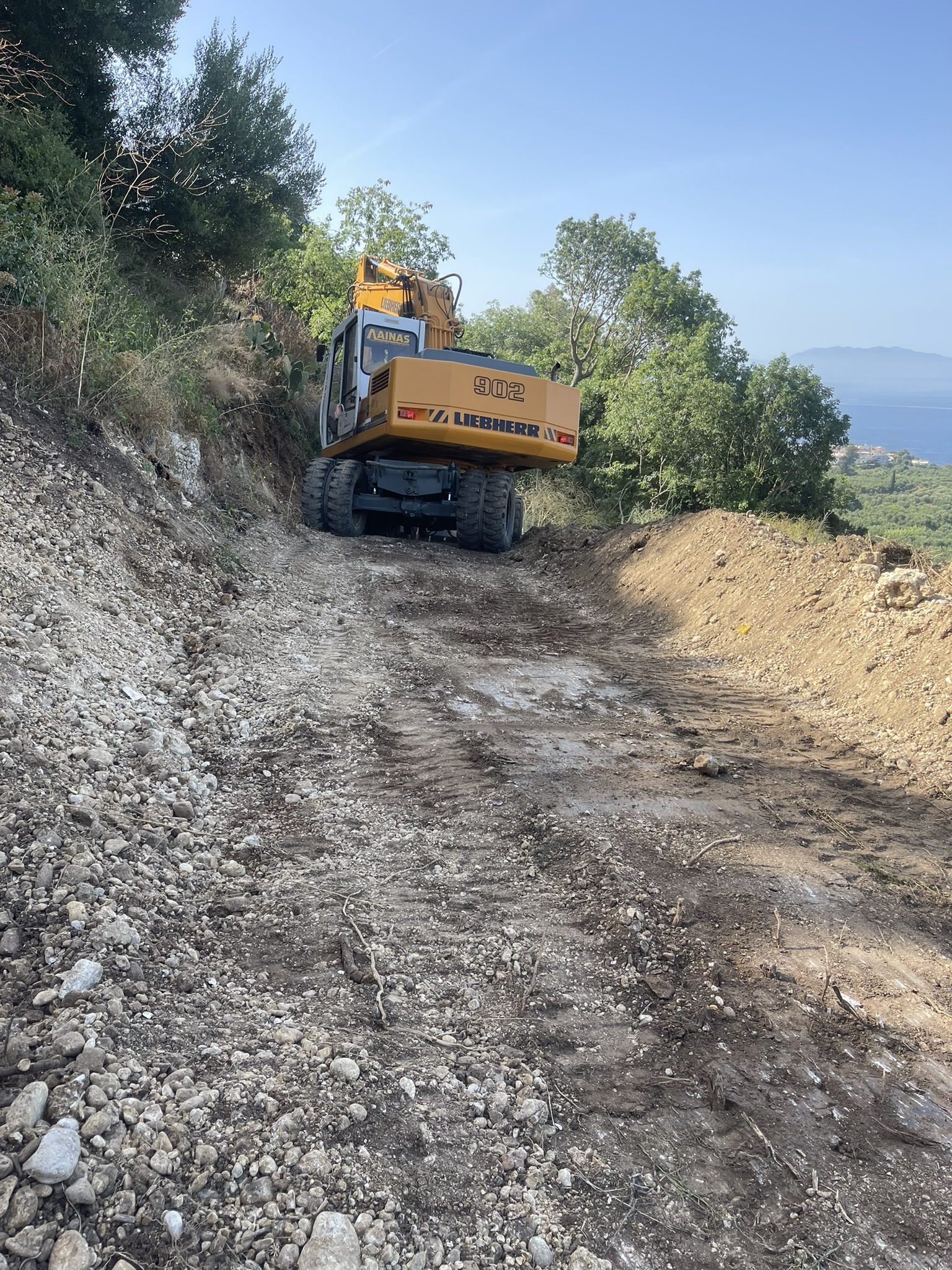

Before anything is designed, we check access, slopes, roads, crane capability, planning restrictions and permitting route. If you plan traditional wooden house in Lefkada, the roof form and facade materials are checked here.

  • Truck and crane access.
  • Slopes, foundation and geotechnical image.
  • Town planning rules for height, roof and views.
02

Phase 2, Architectural study and CLT design

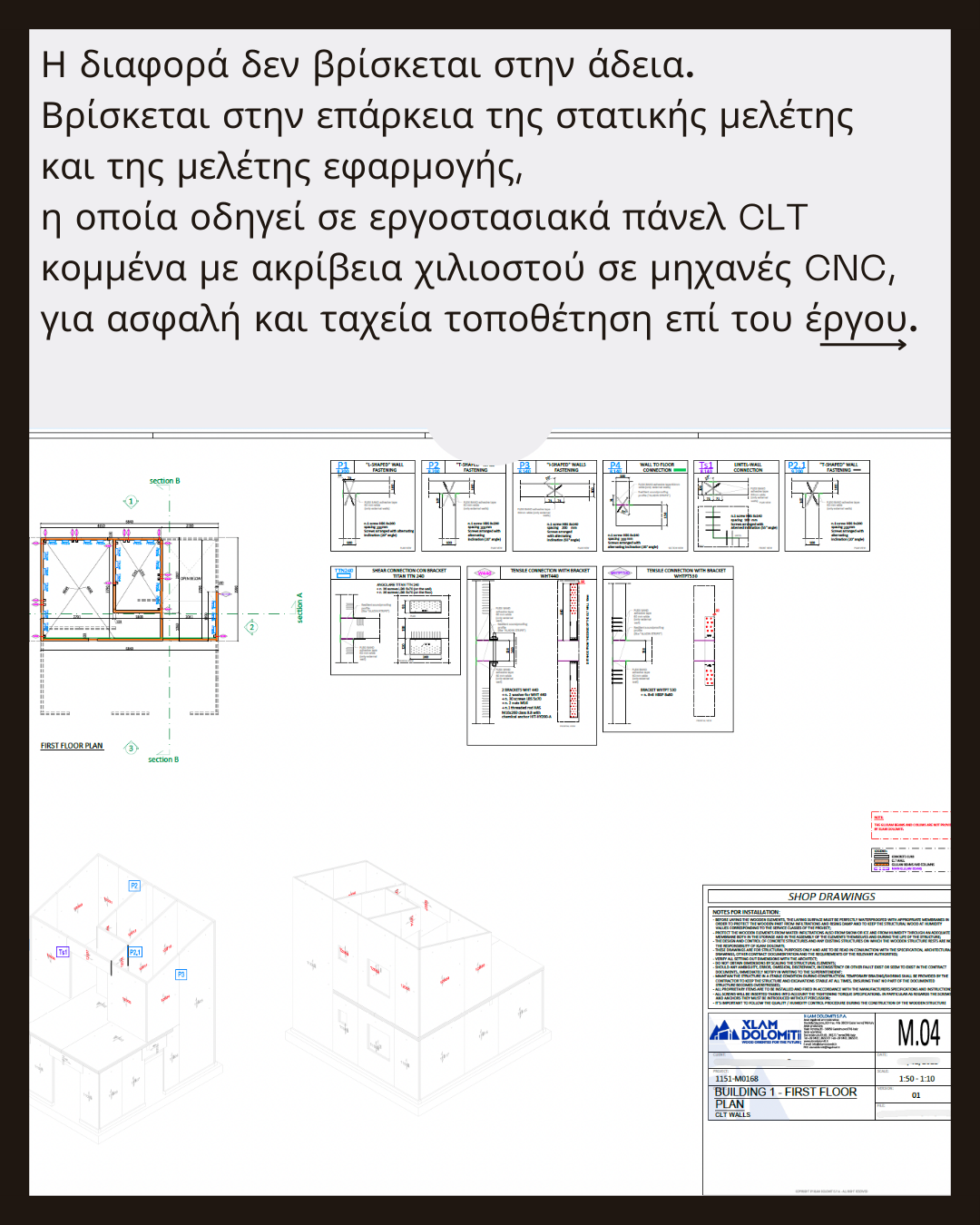

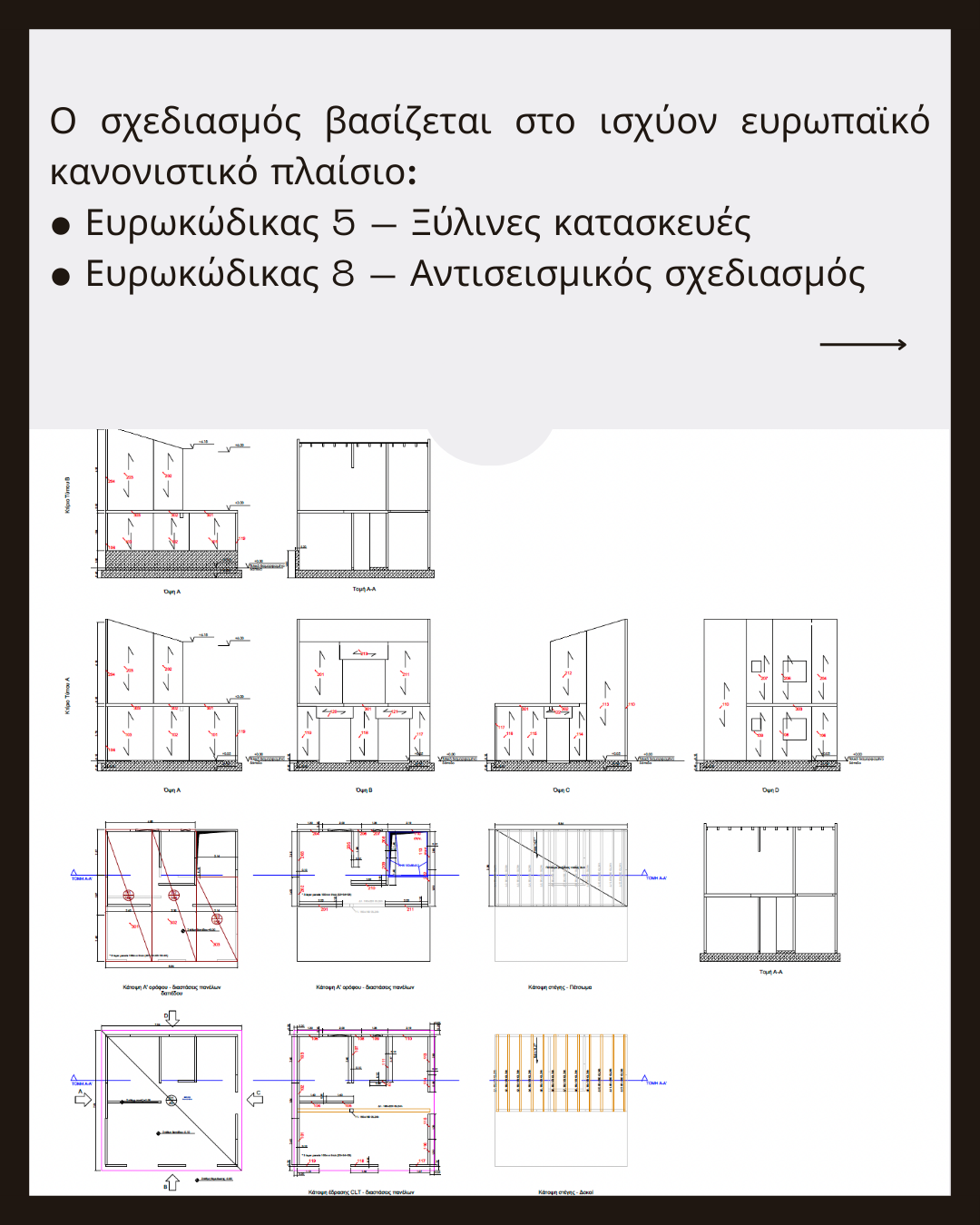

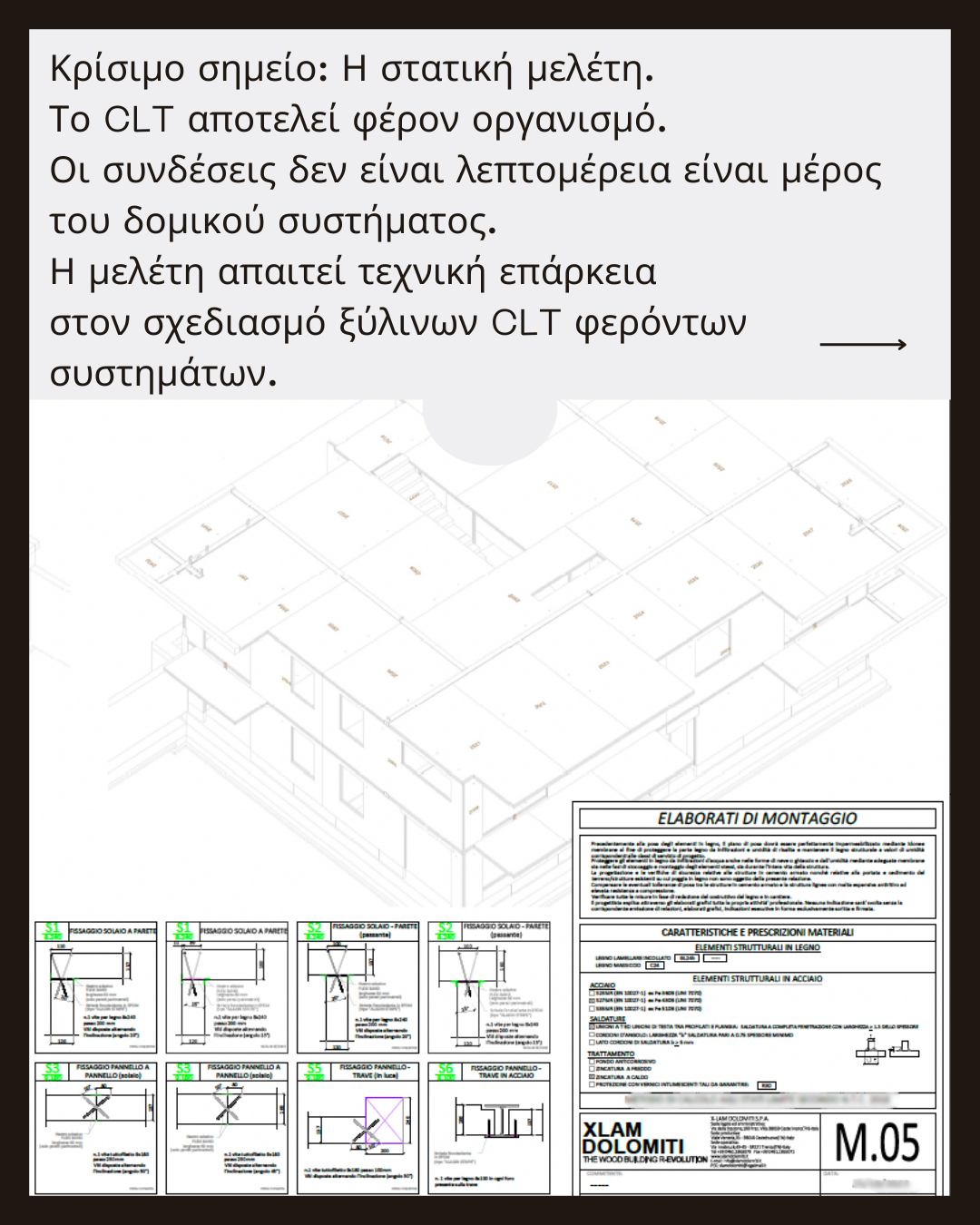

Once the plot is locked, the architectural form turns into a technical system: dimensions of CLT panels, thermal shell, structural analysis, MEP design and details for island humidity.

Related: CLT / mass timber Technology →
03

Phase 3, Off-site production and erection

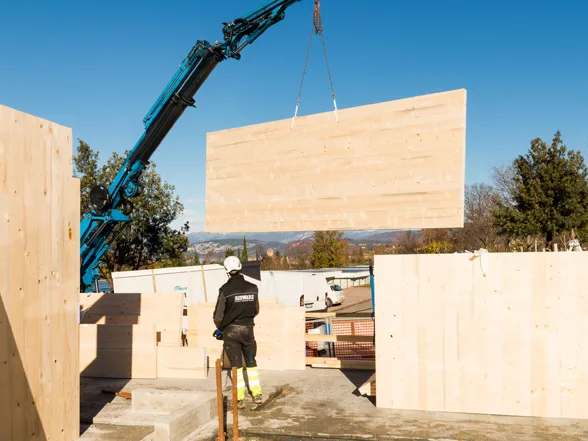

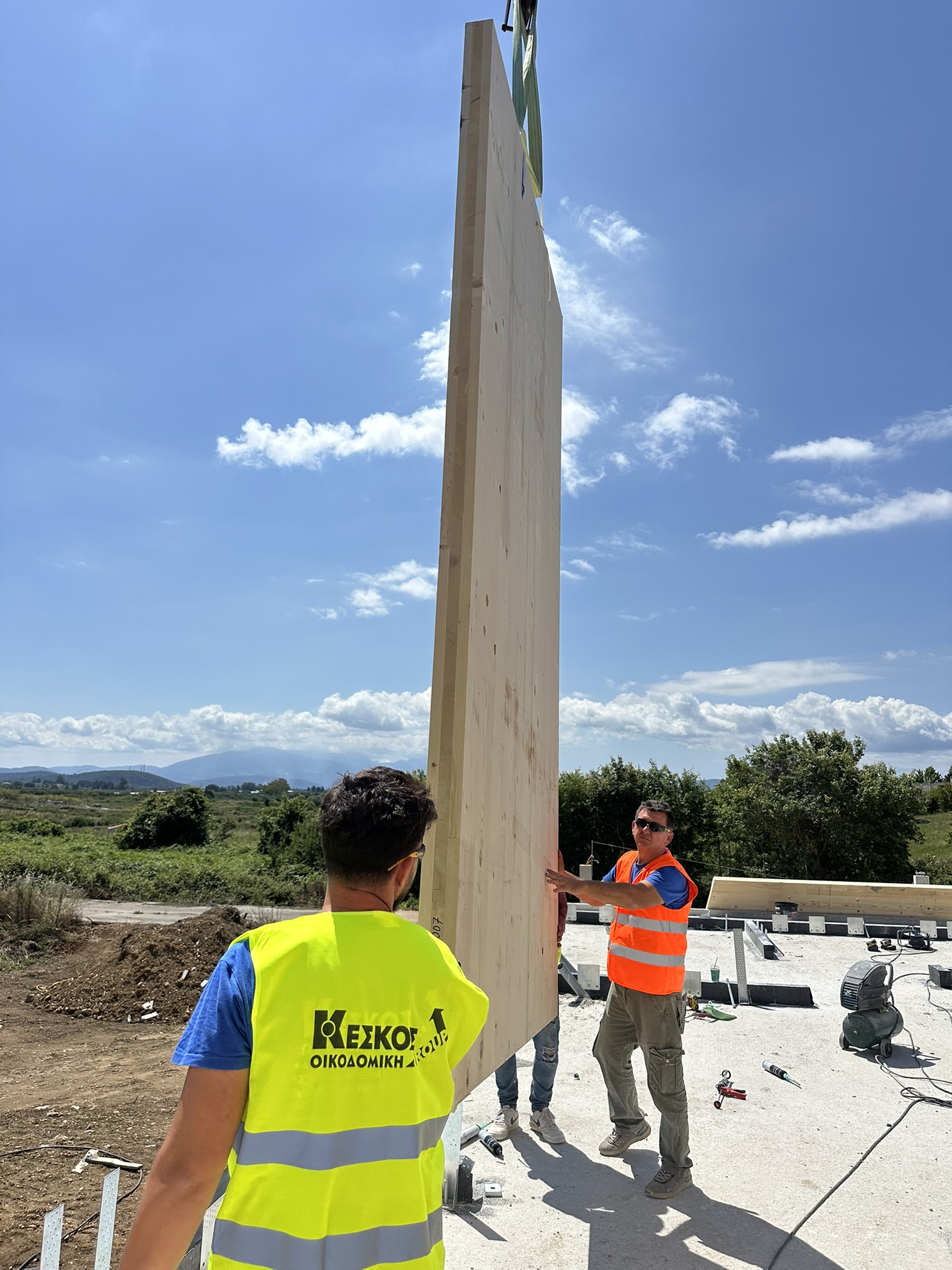

CLT elements are produced in a factory, cut with CNC machines and numbered in order of installation. The transport to Lefkada is organized so that the construction site can receive panels, crane and crews without delays.

Related: CLT construction process →
04

Phase 4, Finishes, Installations and Delivery

After the closed shell come the frames, MEP, roof, linings, floors, paints and technical handover documentation. Delivery is not just handing over the keys, but a clear record of materials, maintenance instructions and warranties.

Related: Roofs and tiled roofs →
What locks before we continue

Each phase reduces the risk of the next

In the first phase, feasibility is keyed in: whether a crane can fit in, how the loads will pass, what constraints affect the height and roof. In the second phase, the technical solution is locked: CLT thicknesses, openings, connections, thermal insulation and installation routes.

In the third phase, the sequence of production and construction is locked. Panels are not generic materials that are cut on site, but numbered elements that arrive in a specific order. In the fourth phase, the final value is locked: roof, frames, linings, technical documentation and maintenance instructions.

This is why a wooden house in Lefkada should be treated as an organized project and not as a simple purchase of materials. Good preparation shows when the site moves quickly, with fewer changes and cleaner responsibilities.

Schedule

How long does a wooden house in Lefkada take?

A realistic schedule for a 100-150 sqm wooden or mass timber home in Lefkada starts at 2-6 months for land and permit, continues with 2-4 months of study and CLT design, 3-6 weeks for production and the basic on-site erection, and 3-5 months for finishes and delivery.

Local context changes the answer. A plot above Agios Nikitas, a narrow approach in Sivota, a rental deadline in Vasiliki, or a steep site near Athani can affect crane staging, delivery windows and the order in which the CLT panels arrive.

Overall, the path from decision to turnkey can be 10-18 months, depending on size, complexity, launch season and Lefkada logistics. For the financial side, see the CLT villa cost in Lefkada.

Next step

Do you have a plot of land in Lefkada? See how construction begins.

Send us the basics, location, size, use and type of roof, and we will send you a first-phase technical assessment: what your site requires, which CLT system fits and what the realistic course of action is.
